Health sector buildings cater for a range of functions, that often change over time, and therefore flexibility and adaptability are essential characteristics to facilitate future re-configuring.
On existing hospital sites, fast construction, generally taking advantage of off-site manufacturing is preferred, to minimise disruption to the hospital.
Other important design requirements for many health buildings include noise and vibration control in sensitive areas such as hospital theatres. Many health buildings require a high level of servicing and therefore the distribution and integration of services within the structure are important design considerations.
The health sector is committed to procuring and operating sustainable healthcare buildings, which places particular environmental requirements on many schemes.
Steel construction enables designers to meet these diverse requirements efficiently and cost effectively.
Attributes of steel construction
Main articles: The case for steel, Infill walling, Cost of structural steelwork, Cost planning through design stages, Cost comparison studies, Sustainability, Service integration, Acoustics, Floor vibrations, Fabrication
Steel construction has many attributes that meet the demands of the health sector and is routinely used to deliver modern, cost effective and sustainable health buildings. Key attributes of steel construction relevant to the health sector include:
- Speed of construction
- Flexibility and adaptability
- Vibration and acoustic performance
- Service integration
- Sustainability.
Increased speed of construction, reduced waste and improved quality are achieved due to the off-site nature of steelwork fabrication. Not only is steel a clean, reliable, quality assured product, it also provides solutions that successfully meets strict NHS requirements for acoustic performance and reducing sensitivity to floor vibrations.
Speed of construction
- Reduced site preliminaries (site management costs)
- Creation of a ‘rapid dry envelope’ for early fit-out
- Installation of modular or pre-fabricated services
- Earlier return of investment.
The time-related savings can represent 3 to 5% of the overall hospital project value and are crucial in the decision-making process for major projects.
Flexibility and adaptability
Long-span steel construction creates column-free space and allows internal partitions to be configured on the floor plan to meet the current and future needs.
Shallow floor systems can provide a ‘flat’ soffit without down-stand beams and permit complete flexibility of layout of internal walls.
Light steel internal walls can easily be relocated, leading to fully adaptable buildings to meet future needs.
Quality
Factory-controlled production is used to improve construction quality. Off-site construction reduces dependency on site trades and is less prone to delays as a consequence of inclement weather.
Steel does not suffer from creep or shrinkage, and does not rot or decay.
Modular components, such as bathrooms and ‘clean rooms’ achieve much greater levels of quality (compared to traditional on-site construction) and can be commissioned and/or tested off-site.
Minimised disruption
- Off-site prefabrication
- Reducing materials use and waste
- Minimising noise, dust and vibrations
- Minimising deliveries of materials to site
- Reducing the construction period.
Cleanliness
Painted steel surfaces can be easily kept clean, free from dust and contamination.

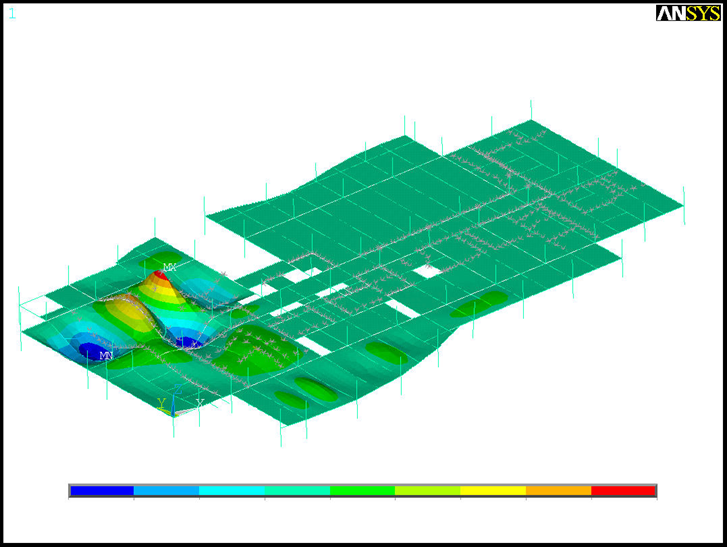

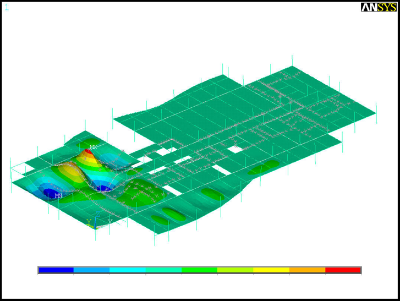

Vibration and acoustic performance
Steel construction can be designed to achieve high levels of acoustic insulation and low vibration response to meet stringent NHS requirements, without compromising structural efficiency.

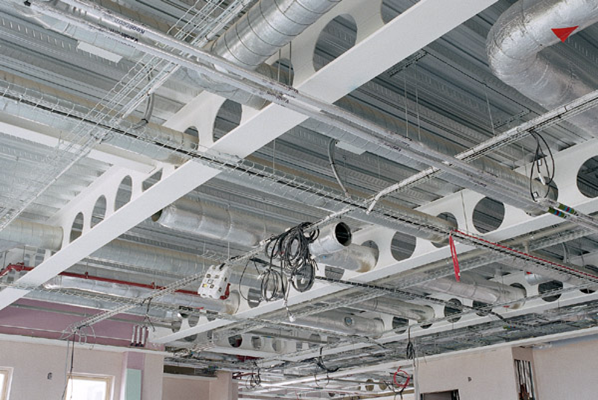

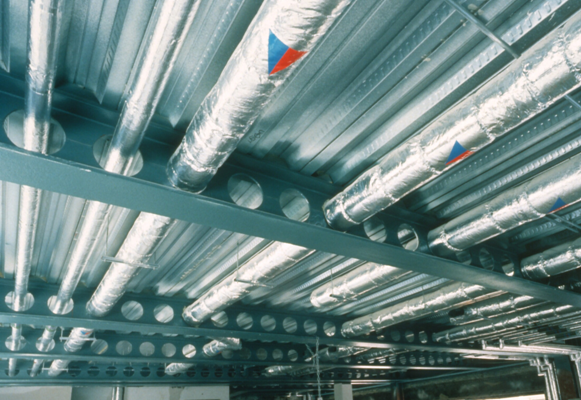

Service integration
(Image courtesy of Kloeckner Metals UK Westok)
Where the service provider can influence the initial design (as is usually the case in PFI projects), services can be distributed efficiently below down-stand beams.
Thermal insulation of cladding
Light steel infill walls can provide a high degree of thermal insulation. The insulation material is placed outside the steel frames to create a ‘warm frame’, which reduces thermal bridging. A variety of cladding materials may be used to provide additional insulation.
Environmental benefits
Steel structures are resource efficient. Waste is minimised and can be recycled multiple times without any degradation in terms of properties or performance. Current recovery rates from demolition sites in the UK are 99% for structural steelwork and 96% for all steel construction products – figures that far exceed those for any other construction material. The sustainability attributes of steel construction enable health buildings to achieve the highest BREEAM ratings.
Anatomy of a typical health sector building
Main Articles: Long-span beams, Multi-storey office buildings, Concept design, Service integration
The health sector comprises a range of building types including hospitals, health centres, diagnostic and treatment centres, GP surgeries, etc. which can vary significantly in terms of form, scale, layout, etc.

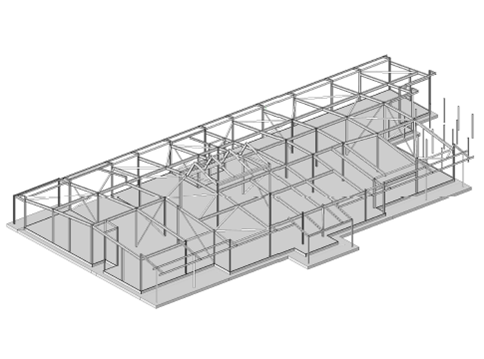

(Image courtesy of Ramboll)
In all healthcare buildings emphasis is placed on flexibility, ease of access, suitably sized spaces, welcoming and friendly environments and user satisfaction. Building design is therefore focused on patient experience and community needs.
From Health Building Note 22Accident and emergency facilities for adults and children. 2nd edition (includes 2006 amendment), 2005. NHS Estates
The principal requirements of healthcare buildings are to facilitate the efficient delivery of quality healthcare and provide a positive environment for speedy patient recovery. Whole life cost and value are also important considerations. Health sector buildings comprise a wide range of scales and functions, and therefore various structural solutions are possible from multi storey hospitals with dedicated operating theatres, specialist facilities, and open plan reception space to a local surgery or medical centre with only a few examination rooms.
In terms of structural solutions, hospital buildings share many of the characteristics of multi-storey commercial buildings. The structural framework is conventionally on a 7m to 9m grid. Improved future flexibility can be achieved by the use of long-span beams.
Long span solutions are also attractive in hospitals, because services can be integrated within the structural zone and pass between and through down-stand beams. In heavily serviced areas Shallow floor systems can be used to minimise the structural floor depth.

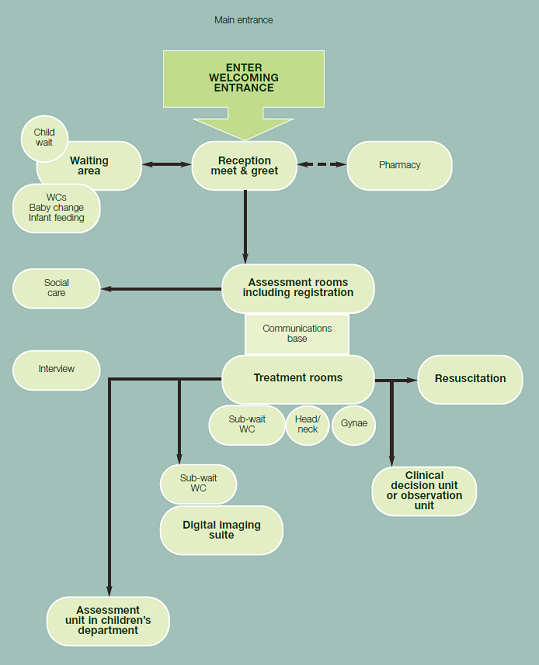

In contrast to other building types, the efficient layout of healthcare buildings and the location of complex functional or specialist spaces are essential to minimise unnecessary patient travel, to increase productivity of the facility, and to improve circulation.
Forms of construction
Main articles: Braced frames, Continuous frames, Composite construction, Floor systems, Long-span beams, Infill walling, Modular construction
Health care buildings can generally be classified as:
- Small medical centres and surgeries
- Diagnostic and treatment centres (DTCs)
- District and regional hospitals.
The typical structural forms for each of these generic building types are a function of the building size and height, the space utilisation, the need for specialist facilities and circulation space, etc. The solutions range from:
- Steel beams with precast concrete or composite slabs for buildings of spans up to 9m
- Modular construction for mainly cellular space, particularly in hospital extensions, where speed of completion of the project is crucial

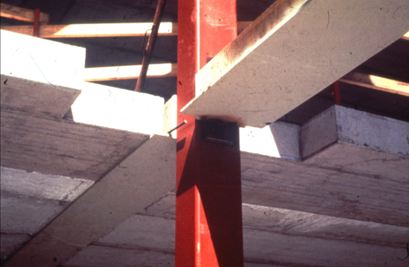

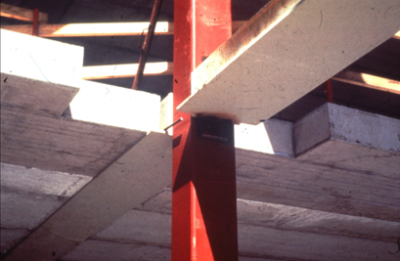

- Shallow floor systems for medium-sized buildings often with special control of vibrations and requirements for service routing, with spans up to 9m

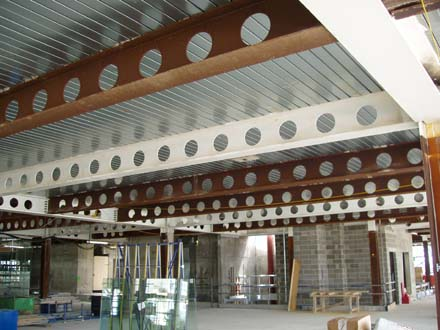

- Steel beams with multiple circular openings (cellular beams) for larger multi-storey hospitals in which the adaptability of space use is the controlling factor. Spans up to 18m are readily achieved.
Steel construction building systems offer a variety of solutions for health care building design to cater for different needs associated with particular projects. Steel composite floor systems create conduits for services and ventilation as well as achieving good acoustic performance.
Light steel walls and modular construction allow for speed of installation and flexibility of design. The following steel systems offer adaptable and flexible solutions to designers.

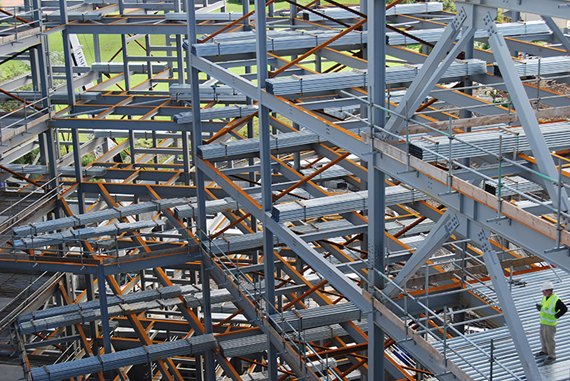

Braced frames
Bracing can be in the form of X bracing using cross-flats that can be incorporated around building cores and in brickwork cavity walls. Alternatively, K or V bracing may use hollow sections, and can be efficient where used around windows, etc.

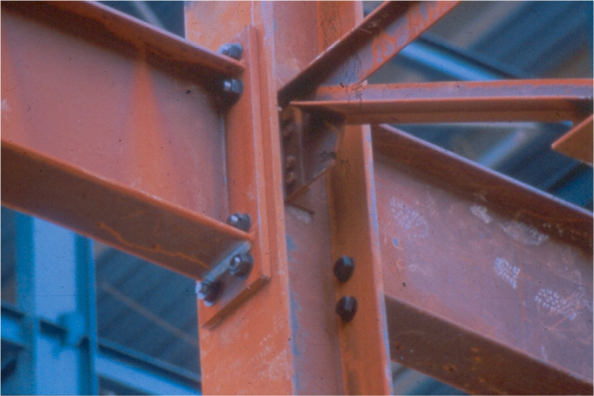

Rigid frames
Composite construction

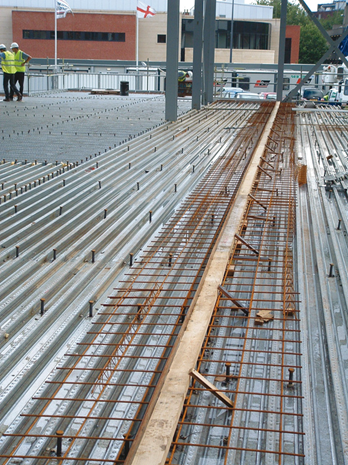

In composite slabs, the steel decking acts as permanent formwork and, after the concrete has gained strength, provides sufficient shear bond with the concrete for the two materials to act compositely. In addition, the decking provides a safe working platform during construction and provides for diaphragm action so that no horizontal bracing is required.
Composite beams are hot rolled or fabricated steel sections that interact compositely with the floor slab by shear connectors attached to the top flange and welded through the steel decking. Relatively light mesh reinforcement is placed in the floor slab.
Down-stand beams acting compositely with the slab through welded shear connectors, provide excellent stiffness and economy in use of materials. For normal design, beam spans up to 18m are achievable using standard rolled steel sections.
Composite slabs normally use decking of 45mm to 80mm depth to create a 120mm to 160mm deep slab. Deck spans of 2.5m to 4.5m can be achieved without requiring temporary propping, and composite action is sufficiently good that heavy equipment may be supported. Services can be suspended from the soffit of the floor slab.
Long span beams
Floor systems
Steel construction offers a wide range of floor systems including:
- Short span composite beams and slabs with steel decking
- Shallow floor system using a deep composite slab
- Shallow floor system with precast concrete units
- Composite or non-composite beams with precast concrete units
- Long span cellular composite beams with multiple circular openings supporting composite slabs
- Long span composite beams and composite slabs.
Cores
Lateral loads are transferred through floors to the bracing or shear walls in a building. These lateral forces are particularly large in the case of tall buildings and can be resisted by reinforced concrete cores acting as deep cantilever beams fixed at foundation level.
Concrete core walls form the enclosure around lifts, stairwell and services. These walls are very rigid in their own plane, which makes them effective in providing overall stability and in minimising deflections. Another function of cores is contributing to building compartmentalisation for the requirements of fire design. In hospitals, the core space is often relatively large because of the need to transport beds and other equipment rapidly around the building.
The introduction of cores in low rise buildings is not recommended, as it is less efficient than braced steelwork and may add to the construction time.
Where overall stability is provided by a concrete core, the connection between the steel frame and the concrete core requires special consideration. Guidance for the design of cast-in steel plates for connecting structural steel beams to concrete core walls is available in SCI-P416.

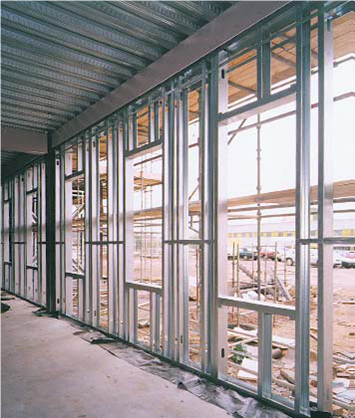

Infill walling
(Image courtesy of Metsec plc)
Light steel infill walls use galvanized steel, typically 1.2 to 2.4 mm thick, roll-formed into C-sections of 75 to 200 mm depth. Separating walls use double C-sections and, with suitable insulation materials, achieve excellent acoustic performance and fire resistance. These walls are lightweight and can be dismantled and moved easily. They create a ‘rapid dry envelope’ early in the construction process, which facilitates installation of services and fit-out.
Infill walls are used on the facades or atria to transfer wind loads and to support the cladding. They span between the floors and are attached to them with provision for relative movement at the ‘head’ of the wall. When supporting brickwork, the infill walls provide only lateral restraint and so separate support at the slab edge is required for brickwork more than 12m high (3 storeys typically).
The attributes of light steel infill walls are:
- Lightweight wall construction with minimal wastage of materials
- Rapid on-site construction
- High level of thermal and acoustic insulation
- Freedom in window pattern and size
- Direct support to light weight cladding.
Separating walls within the building may be constructed with light steel sections but the steel thicknesses will be reduced because of the lighter loads that they are designed to carry. The same type of construction may be used around lift shafts in braced steel frames. In all cases, these walls can be modified, dismantled, and re-located without affecting the rest of the building.

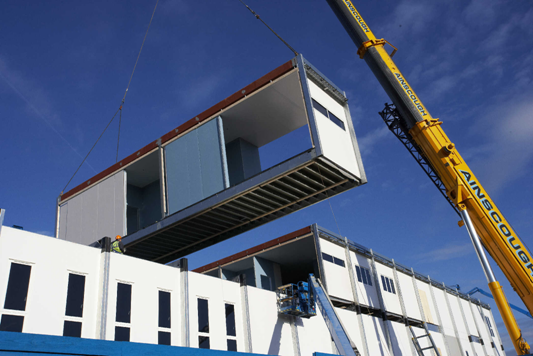

Modular units
(Image courtesy of Yorkon)
Modular construction has a strong market in hospitals and specialist medical facilities mainly because of speed of construction and the ability to pre-install and pre-test complex equipment and services. A niche market is in extensions to existing hospitals and particularly single storey roof-top extensions, where modular units are placed on beams that span over the existing roof. In this case, the installation of the modules causes almost no disruption to the operation of the existing building.
Modules are generally four-sided but can be manufactured with fully open sides to provide open plan space. In this case, the horizontal stability of the group of modules is very important, and so modular buildings of this type are often low-rise. Spans of up to 12m can be achieved in modular construction.
Procurement, cost and programme
Main articles: Cost of structural steelwork, Cost planning through design stages, Cost comparison studies
Procurement routes
Framework Partnering, Private Finance Initiative and Local Improvement Finance Trust are currently the main routes for the procurement of capital schemes used by the public healthcare system in the UK. For all procurement routes, there is a need to demonstrate that the scheme is viable within the required timescales and provides good value for money.
Framework Partnering
Framework Partnering was first developed as ProCure21 and functioned as such until 2010 when superseded by ProCure21+. Under this framework NHS Clients were enabled to achieve improved levels of performance and value for money than those historically achieved using what is referred to as ‘traditional tendering’.
The ProCure21+ National Framework is a framework agreement with six Principal Supply Chain Partners (PSCPs) that have been selected via an Official Journal of the European Community (OJEU) tender process for capital investment construction schemes across England up to September 2016. ProCure21+ is a suitable procurement route for a broad range of work in this sector, and uses the NEC3 Option C: Target cost contract with activity schedule, which requires the principles of ‘open book’ accounting to be applied by PSCPs and their supply chains.
ProCure22 replaced ProCure21+ on the 1 October 2016 to provide uninterrupted access. P22 is built upon the successes of these earlier frameworks and will continue to support the NHS to masterplan their estate reconfigurations, carry out extensive maintenance and refurbishment programmes and deliver small and major capital construction work. One of the key aspects of P22 is the implementation of Building Information Modelling software on all schemes.
Private Finance Initiative (PFI)
The Private Finance Initiative (PFI) is a procurement route established in 1995, and was aimed at introducing private sector resources to develop public sector assets and services. PFI requires private sector consortia to raise private finance to fund projects, which involves investment in assets, and the long-term delivery of services to the public sector. PFI is not normally considered best value for smaller projects as it tends to have high up-front transaction costs and fees.
Local Improvement Finance Trust (LIFT)
The Local Improvement Finance Trust (LIFT) initiative is a nationally led, locally delivered investment programme bringing the public and private sectors together via a special purpose joint venture company (LIFTCo) - to deliver community based estate solutions. In 2009, following the successful establishment of 47 LIFT companies covering more than half of the population of England, Express LIFT was developed to provide a 'fast-track' procurement route to allow public sector organisations who are not currently in a LIFT area to establish a LIFTCo, with a partner taken from a nationally procured framework of approved partners, without the need for a 'traditional' competition based around the design of sample schemes. At the end of the process, public sector participants will have a partner who will be able to help them finalise the Strategic Services Development Plan (SSDP) and then implement it in a cost effective manner.
The creation of a LIFTCo establishes a long term partnering agreement between this company and a range of local public sector organisations. A LIFTCo is a public/private partnership with a focus on delivering support and investment in partnership with the social care economy.
Cost
Specific guidance on the cost planning of steel framed healthcare buildings is available that builds on the general guidance on the cost of structural steelwork, and cost planning through design stages for structural steel framed buildings by considering the typical design and construction characteristics of healthcare buildings. It explores the importance of programme, the key cost drivers for the healthcare sector and the principal factors to consider when using standard cost ranges to ensure that realistic cost plans are produced during the design and early stages, when a number of frame options may be under consideration. .

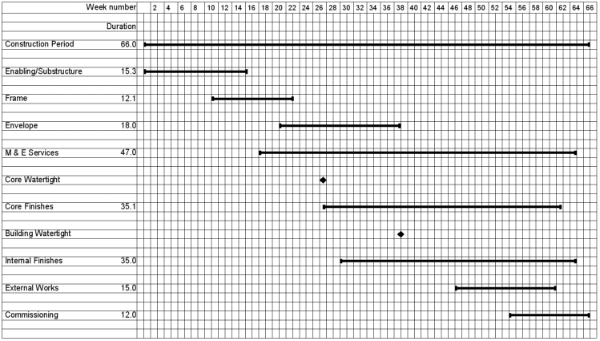

Programme

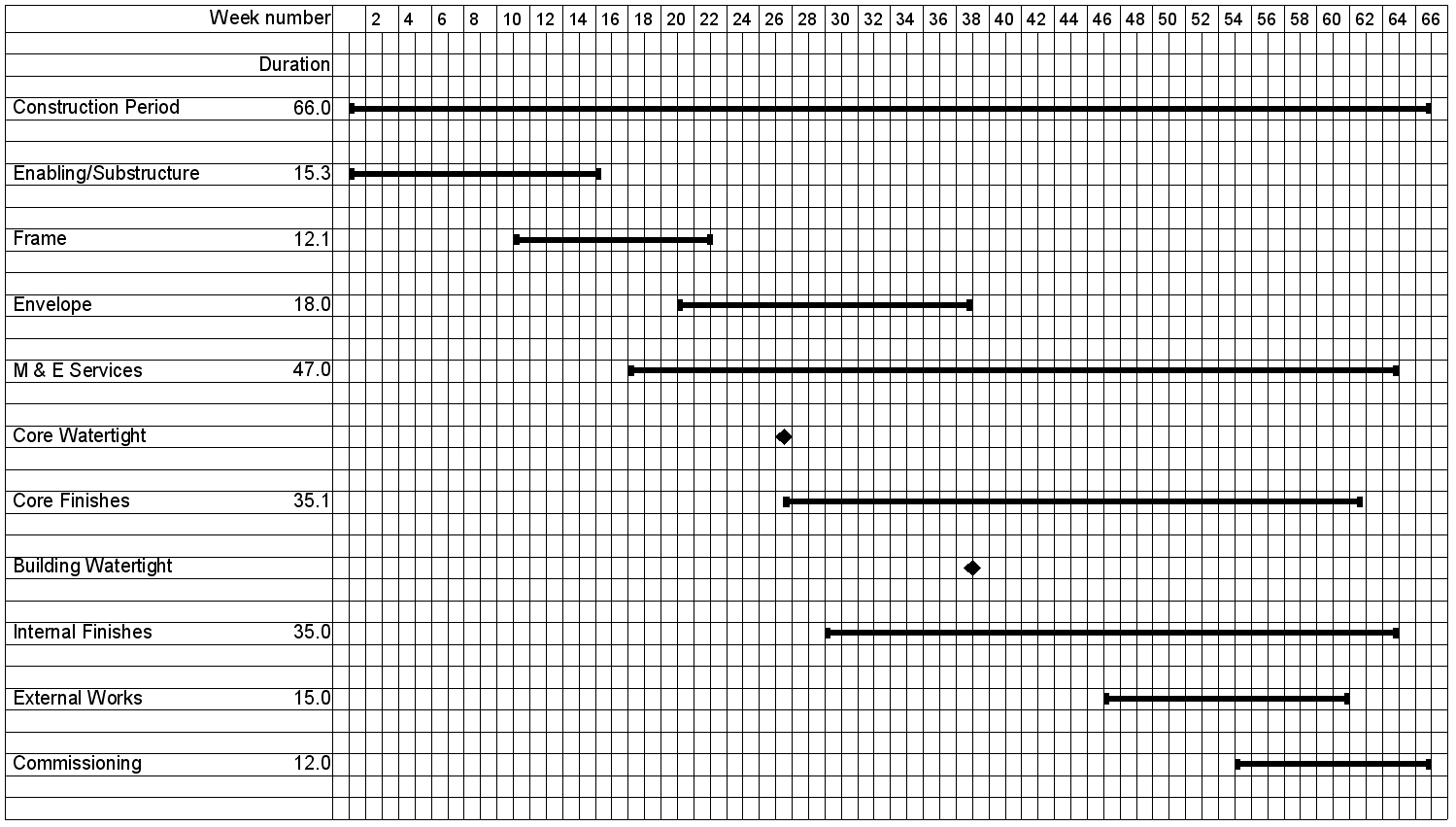

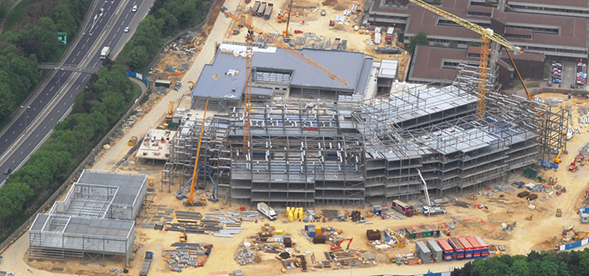

For large buildings, erection rates are dominated by ‘hook time’ – the time connected to the crane, which is minimised using steel construction. The number of cranes on a project will be dictated by:
- The site footprint – can more cranes be physically accommodated on the site?
- The size of the project – can more than one crane be utilised efficiently?
- Commercial decisions on cost and programme benefits.

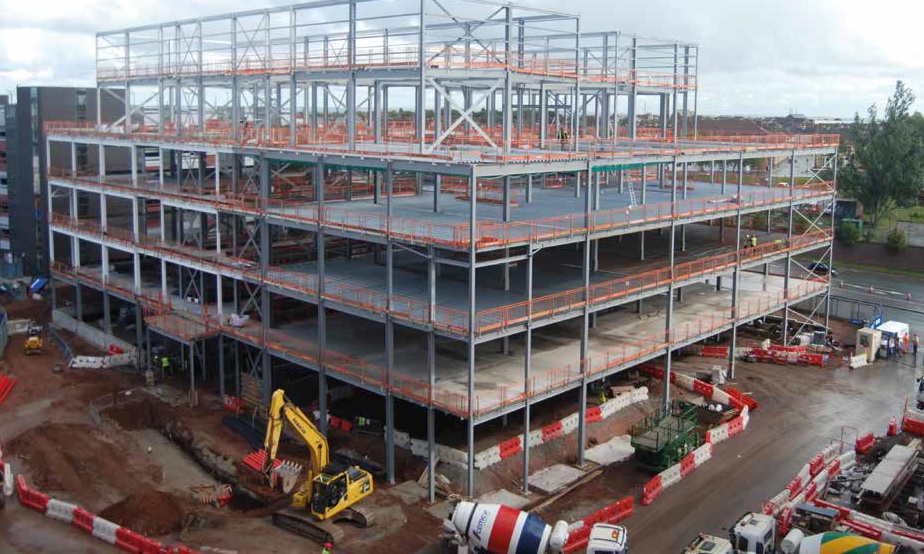

Like all multi-storey structures, hospitals are often erected using a tower crane. Long-span steel systems in which bundles of steel decking are installed by crane are fast to construct and facilitate an early start on servicing and infill walling, etc. Modular services and plant rooms can also be installed at this stage. A typical construction programme for a medium size multi-storey steel framed building is shown.
Using steel construction, reductions in construction programmes of 20 to 40% can be achieved relative to site-intensive construction, which lead to commercial benefit to the client by reducing borrowing costs, providing earlier return on the investment and also reducing site management costs (preliminaries). In many hospital projects requiring new buildings on the existing site, minimising disturbance is the key requirement and steel construction is fast, quiet and has few vehicle movements.
Sustainability aspects
Main articles: Sustainability, Operational carbon, BREEAM, Target Zero, The case for steel
As a leader of health and social care systems, the Department of Health & Social Care aspires to excellence in sustainability in healthcare.
Sustainable construction matters to everyone involved in the provision and delivery of healthcare services and to all those who use these services. Close local partner and community engagement in the design and development of local healthcare services lie in the heart of ‘sustainable communities’. Following the sustainable drive, healthcare organisations can benefit from a healthier population, improved staff morale and faster patient recovery rates.
Steel framed structures routinely achieve the health sector’s sustainability goals. Environmental criteria are addressed, as steel is one of the most recovered and recycled materials, gives flexibility for change in use, can also be dismantled and re-used. Highly optimised use of material, almost complete elimination of waste, low investment costs and optimum operational costs coupled with high quality, functionality, aesthetics and fast construction times account for steel buildings economics.
The high proportion of off-site fabrication in steel buildings means that working conditions are safer than for traditional, site-based construction and factory-based steel construction workers are protected from the weather. A fixed manufacturing location means stability for employees helps to develop communities, family life and the skills. Steel buildings releases no harmful substances into the environment and provide a robust, safe solution.
Life cycle costing
Health Technical Memorandum (HTM) 07-07[1] recommends that healthcare organisations should adopt a life-cycle costing approach. This approach is relevant throughout the building life-cycle, in particular during the project planning, design, construction and in-use phases.
The life-cycle costs of a hospital include design, construction and equipment, operating and maintenance over its whole life through to its upgrading and ultimately to its end-of-life. Taking the whole-life approach requires that a wider economic evaluation is made of:
- Business and financing costs, etc.
- Operational and maintenance costs
- Design life and replacement of items of equipment and other facilities
- Environmental benefits (for example operational carbon reductions)
- Health benefits (for example improvements in internal environments).
BREEAM for Hospitals
(Image courtesy of Severfield plc)

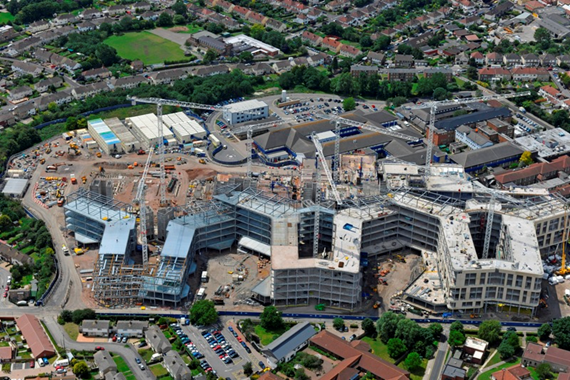

In 2002, the National Health Service introduced the BREEAM based NHS Environmental Assessment Tool (NEAT), which was replaced by BREEAM for Health (B4H) in 2008, which was superseded in turn by BREEAM New construction 2011 which covered healthcare buildings. The current version for UK non-domestic new buildings is BREEAM 2018 New Construction[2], which includes in its scope:
- Teaching or specialist hospitals
- General acute hospitals
- Community and mental health hospitals
- GP surgeries
- Health centres and clinics
BREEAM is now a preferred environmental assessment method and certification scheme for healthcare buildings in the UK. The Department of Health requires, as part of the project approval and condition for funding, that all new builds achieve an ‘Excellent’ rating and all refurbishments achieve a ‘Very Good’ rating.
BREEAM can be used to assess healthcare developments at both the Design and Post Construction stages of their lifecycle. Since 2008 it has been compulsory to undertake a ‘Post Construction Review’ to confirm that the ‘as built’ information correlates with the design information.
Minimising operational CO2 emissions
As part of the national effort to reduce national green house gas emissions, the UK Government was implementing increasingly stringent targets to reduce operational carbon emissions from buildings. For non-domestic buildings, the target was for new buildings to be ‘zero carbon’ in operation by 2019. On the trajectory to zero carbon, emissions reduction targets were to be introduced via Part L of the Building Regulations.
However,in July 2015, the UK Government announced that it did not intend to proceed with certain zero carbon schemes, and that energy efficiency standards were under review. It has been widely accepted that it means that the 2019 target for non-domestic zero carbon buildings has been dropped.
Nevertheless, health building designers still ought to seek robust, durable but adaptable, low maintenance solutions which aim to minimise adverse effects on the environment both under construction and in use.
'Steps towards lower carbon footprint'
In order to minimise the CO2 emissions associated with a building, designers should consider the whole life cycle, taking a cradle-to-cradle approach, from building component manufacture, construction through operation to demolition and recycling. The greatest savings in CO2 emissions can be made by optimising the operational energy performance of the building in use.
In designing low carbon buildings, there is a clear hierarchy for the designer to follow:
- Minimise the requirement for servicing by a combination of efficient building design and energy conscious building use
- Optimise the building envelope, balance the heat losses, solar and lighting gains in the most cost effective manner
- Deliver the heating, ventilation and artificial lighting as efficiently as possible using the most appropriate technology for the building type together with an energy saving control system
- After taking all practical steps to minimise the demand for energy, source the residual energy requirement as far as possible from low carbon or renewable means.
Renewable energy systems
Renewable energy can be built into for healthcare buildings in the following ways:
- Renewably sourced energy can be bought from electricity suppliers
- Green energy can be generated within the NHS trust. Most trusts are significant property owners; and have 24-hour year round demands for electricity and heat
The most suitable renewable energy options for use within NHS trusts include:
- Solar – natural-lighting, solar electric (PV) and solar water heating
- Wind – a range of different devices including wind turbines, although these are less suitable for urban sites
- Bio fuels – such as site waste, straw and wood for direct heating or gasification, and sewage for gas generation (which can be used to drive Combined Heat and Power (CHP))
- Ground linking – geothermal, groundwater, ground linking either for cooling or heating with or without heat pump gearing.
The following application of these technologies is identified in health sector buildings.

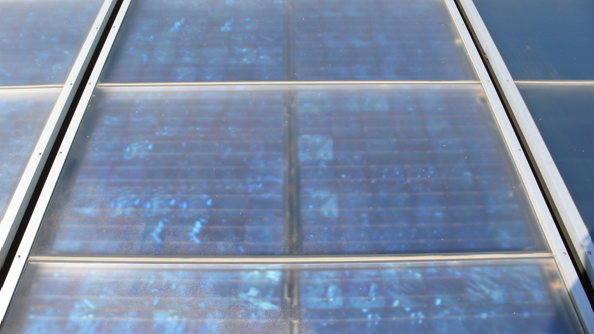

Solar electricity (photovoltaics)
The solar photovoltaic (PV) systems are a reliable, use a widely available resource but rely on a large roof or inclined surface on which the PV panels can be placed in the optimum direction for the sun (generally south east to south west orientation) at an optimum inclination at about 30º to the horizontal.
Solar thermal
Hospitals have a steady demand for hot water throughout the day, which allows the solar system to maintain optimum efficiencies if solar pre-heating of hot water is included.
Solar thermal panels are most effective in raising water temperature from ambient levels (normally 10°C) to 30 or 40°C. In winter, solar-thermal hot water heating panels can effectively contribute to the pre-heating of domestic hot water (DHW).
The principal health trust applications for solar thermal heating is the provision of pre-heated cold water via preheat tanks for existing DHW systems and heating for swimming pools and other treatment pools.


Biomass
Biomass includes: wood and forestry residues; recovered wood waste; straw; short-rotation crops (such as coppiced hazel); and poultry litter etc.
Design guidance
Main articles: Design, Service integration, Fire and steel construction, Acoustics, Construction, Fabrication, Floor vibrations
The design of a healthcare building is influenced by a number of factors, which includes physical issues like surrounding buildings, orientation, site and environmental constraints and operational issues such as care brief, department relationships, circulation and access space, security and infection control, etc.
Special requirements
From April 2013, all guidance on health related issues has been available from the individual web sites for England (Search for ‘health building notes’ and ‘health technical memoranda’ to open the full series), Wales, Scotland and Northern Ireland.
Health Building Notes (HBN) and Health Technical Memoranda (HTM) outline special requirements for health care buildings. Health Building Notes provide a set of requirements across the range of care and patient experience. Core subjects are subdivided into specific topics.
These provide technical guidance on:
- Policy and service context information for healthcare premises
- Planning and design information for healthcare premises, including technical and engineering information
- Access to archived Government-published healthcare premises guidance
- Cross-references to regulations, legislation and other information sources.
Health Technical Memoranda cover installation and operation of specialised building and engineering technologies used in the delivery of healthcare. The focus of HTM guidance remains on healthcare specific elements of standards, policies and established best practice. They are applicable to new and existing sites, and are for use at various stages during the whole building lifecycle.
|
Health Technical Memorandum |
Subject |
|---|---|
|
00 |
Policies and principles (applicable to all HTM in this series) |
|
01 |
Decontamination |
|
02 |
Medical gases |
|
03 |
Heating and ventilation systems |
|
04 |
Water systems |
|
05 |
Fire safety |
|
06 |
Electrical services |
|
07 |
Building planning, construction and sustainability |
|
08 |
Specialist services |
Some HTM subject areas may be further developed into topics shown as -01, -02, etc and further referenced into Parts A, B, etc.
All of the above documents are relevant for the all-round design of healthcare buildings and their environment however structural designers will be particularly interested in the Acoustics guidance[3].
Services integration
- Vertical and horizontal services routes
- Adequate ceiling space for service distribution
- Use of off-site prefabricated service modules.
Engineering services in hospitals are becoming increasingly complex with the increased use of information management and technology for patient records, etc.
In heavily serviced areas, such as operating theatres and critical care areas, void depths of 1000 to 1200mm are necessary. For less heavily serviced areas, such as wards and outpatient departments (which tend to be naturally ventilated), a void depth of 800mm is generally sufficient, which can be provided by using a mixture of steel frame solutions.
In heavily serviced areas, Shallow floor systems can be used, whilst in other areas, cellular beams or composite beams and slabs can provide an effective solution.
A major benefit of steel-framed buildings is the early commencement of the services installation and the resulting adequate commissioning period. Increasingly, prefabricated service modules and plant-rooms reduce installation time and the resulting improvement in the quality of healthcare projects.
Fire safety
Large buildings are divided up into smaller fire ‘compartments using fire resisting walls and floors. Modern hospitals are designed so that on each floor there is a minimum of three compartments limited to 2000m2. There is also a requirement for compartmentation by department boundaries and in high dependency departments, such as operating theatres and critical care areas. An area larger than 750m2 or where the area provides access to more than 30 patients should be divided into sub compartments.
Guidance on fire precautions in healthcare buildings is widely available. HTM 05-02[4], gives guidance on fire safety. It is accompanied by HTM 05-03[5] specifically dedicated to fire engineering in healthcare premises.
Corrosion protection
The corrosion protection of steelwork in hospitals does have to be considered, but there are no special requirements or considerations over and above those for other types of non-domestic building.
Acoustic performance
Acoustic performance is an important feature for hospitals, as the provision of acoustic privacy is just as important for the creation of an effective healing environment as adequate levels of natural lighting or ventilation. Acoustic performance requirements for healthcare facilities are set out in HTM 08-01[3].
Composite floors and steel frames achieve good acoustic performance. For practical purposes, a screeded floor is normally preferred for hospitals, with or without a suspended ceiling. Typical construction involves a composite floor slab using either conventional shallow or deep decking and a 60mm to 70mm sand and cement screed on top, as shown. For improved performance, a resilient layer may be included at the interface between the composite slab and the screed. The resilient layer can be dense mineral wool, plastic insulant or polyethylene foam and should be turned up at the edge of the floor to isolate walls from the screed.
Acoustic tests on a wide range of composite constructions have been carried out and some recent results are shown in the table below. These demonstrate that an airborne sound reduction of over 63dB (>52 dB required) and an impact sound level of lower than 45dB (<65 dB required) can be achieved without a resilient floor covering.
|
Form of construction |
Airborne sound reduction (dB) |
Impact sound transmission (dB) |
|---|---|---|
|
NHS Standard weighted sound reduction |
>52 |
<65 |
|

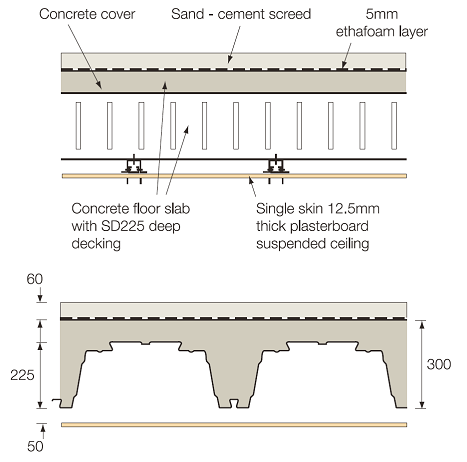

'Deep decking' with 300mm concrete slab and 55mm sand-cement screed on combined 5mm foam & 30mm thick mineral wool resilient layer and plasterboard ceiling |
65 |
45 |
|

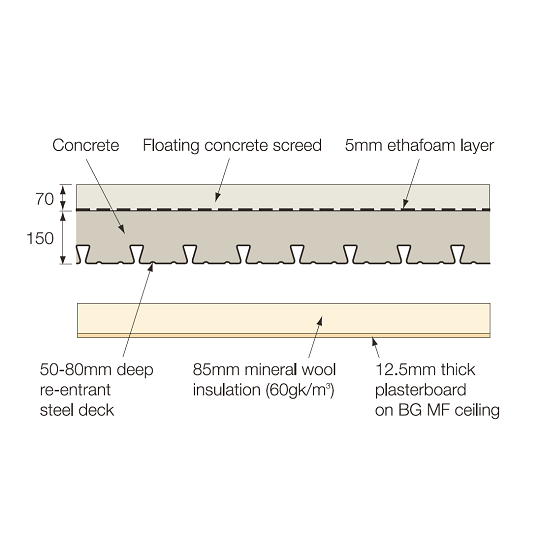

'Shallow decking' with 150mm concrete slab and 70mm concrete screed on 5mm thick foam resilient layer and plasterboard ceiling |
63 |
25 |

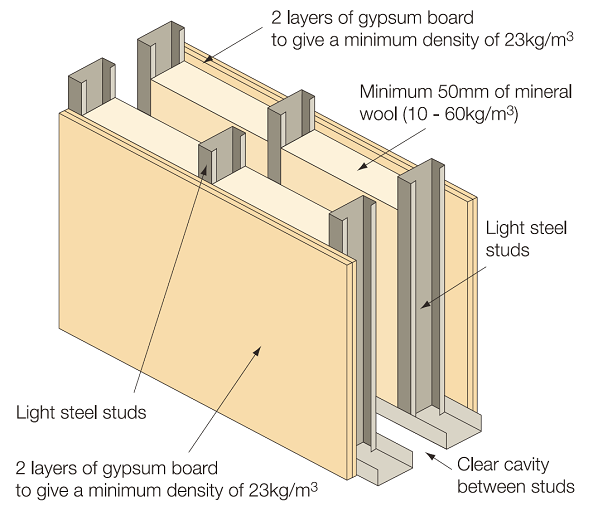

Internal walls in hospitals can be built using light steel construction and separating walls enclosing sensitive areas can be built to a high standard of airborne sound insulation using double leaf light steel construction, as shown. An overall wall thickness of 250mm can be achieved, which is significantly less than in traditional masonry construction.
Floor vibrations
The vibration response of floors is a key issue in the design of hospitals, especially in sensitive areas, such as operating theatres. For floors that are subject to cyclic loading from walking, human perception (and acceptability) of motion is related to acceleration levels rather than displacement; and thus it is acceleration which must be controlled. The evaluation of the exposure of humans to vibrations in buildings is covered in BS 6472[6].
Limits of satisfactory vibration magnitude are expressed in relation to a ‘base curve’ and a series of multiplying factors (sometimes also referred to as ‘response factors’). Response factors appropriate to different types of space in hospital buildings are set out in HTM 08-01[3]. These values are summarised in the table.
|
Space |
Response factor for continuous vibration |
|---|---|
|
Operating theatre, precision laboratory, audiometric testing booth |
1 |
|
Wards |
2 |
|
General laboratories, treatment areas |
4 |
|
Offices, consulting rooms |
8 |
A series of tests on steel-framed hospital buildings have shown that occupant-induced vibrations do not pose a serious problem for sensitive floors. Tests on operating theatres in steel intensive hospitals have, on average, given an in-situ response four times better than the specified recommendation.

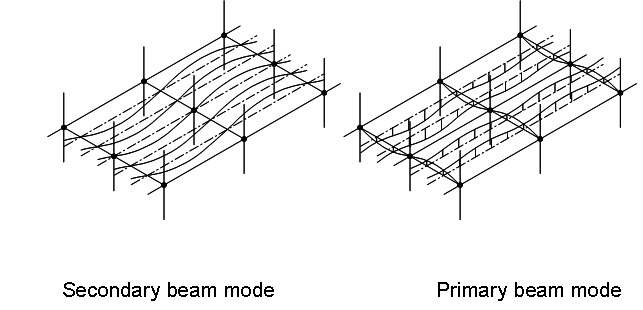

SCI P354 is a design guide that covers human perception of vibration and the criteria by which it is measured and accepted. It explains the concepts of floor vibration response. This includes the primary and secondary beam mode shapes (see below), and the different types of excitation produced by occupant-induced vibration. A design procedure is presented, which shows how to calculate floor accelerations, weight them to reflect human perception, and to compare them to the acceptance levels in HTM 08-01[3]. The Steel Construction: Floor Vibration publication is also relevant, and a useful web-based Floor response calculator is also available to swiftly evaluate the vibration response of floors.
To demonstrate the ability of steel-framed floors to meet the strict NHS requirements for vibrations, a series of tests have been carried out on a variety of hospital buildings. A summary of the results from tests in operating theatre areas is shown.
|
Form of construction |
Fundamental frequency (Hz) |
Response factor |
|---|---|---|
|
Long-span composite beams of 11.3m span with a 300mm deep composite slab |
6.4 |
0.25 |
|
Long-span composite beams of 15m span with a 175mm deep composite slab |
7.6 |
0.49 |
|
Medium-span composite beams of 8.1m span with a 140mm deep composite slab |
8.0 |
0.21 |
These results demonstrate the excellent performance of composite construction, which easily satisfies HTM 08-01[3] limits for vibrations. In addition, numerical modelling using Finite Element (FE) analysis has also been carried out to provide accurate predictions of measured behaviour.
Finite element modelling has been carried out on the shallow floor system for the Diagnosis & Treatment Centre at St Richard’s Hospital, Chichester. These analyses led to significant savings in steelwork and confirmed that the floor met the HTM 08-01 requirements as they existed at the time (2008).
Health & Safety
The designer is obliged to follow the same hierarchy of measures whether considering the construction process or the specification of components, namely to avoid hazards, reduce their impact, or protect people from their consequences. Steelwork contractors are specialist companies who adopt highly sophisticated erection techniques, including installation using mobile platforms (MEWPs). In this case the steel structure is designed to support the temporary weight of the platform which moves along the beams to permit safe erection of the structure on the level above.
Fabrication and construction
In healthcare buildings, as in any other steel framed buildings, high quality control and controlled environment of fabrication of steelwork contribute largely to the success of steel as a construction material. Shop assembly relies mainly on welding, which is performed by qualified operatives according to relevant standards and subject to high level of inspection and control.
Case studies
Resources
- SCI P300 Composite Slabs and Beams using Steel Decking: Good Practice for Design and Construction, (3<sup>rd</sup> Edition), 2023
- SCI P315 Hospitals and Health Buildings using Steel
- SCI P348 Building design using modules
- SCI P354 Design of Floors for Vibrations- A New Approach
- SCI P365 Steel Building Design: Medium Rise Braced Frames, 2009
- SCI P372 Acoustic Detailing for Steel Construction
- SCI P416 The design of cast-in plates, 2017
- Steel Insight 7 – Healthcare, April 2013, Building magazine
- Steel Construction: Floor Vibration, BCSA, 2016
- Floor response calculator
See also
- Infill walling
- Modular construction
- Floor systems
- Services integration
- Acoustics
- Floor vibrations
- The case for steel
- Cost of structural steelwork
- Cost planning through design stages
- Cost planning - Healthcare buildings
- Cost comparison studies
- Sustainability
- Fabrication
- Multi-storey office buildings
- Concept design
- Braced frames
- Continuous frames
- Composite construction
- Long-span beams
- Infill walling
- Operational carbon
- BREEAM
- Target Zero
- Design
- Fire and steel construction
- Construction
- The recycling and reuse survey
